Modernizing a fleet is never easy, but when a billion-dollar program intended to extend the life of vital naval assets ends up as an example of inefficiency and waste, the implications go beyond mere budgeting errors. The Government Accountability Office (GAO) report released last December 17 shines a harsh light on the US Navy’s 12-year effort to modernize its Ticonderoga-class cruisers—a program that cost taxpayers $3.7 billion but ultimately resulted in the premature decommissioning of four ships and $1.84 billion wasted.

This ambitious project, marred by poor planning, oversight failures, and contractor missteps, underscores the need for reform in how the Navy approaches major modernization efforts.

The Ambitious Plan and Its Fallout

The Navy launched the phased modernization program in 2012 with the goal of extending the service life of aging Ticonderoga-class cruisers into the 2030s. At its inception, the program was seen as a compromise after Congress denied the Navy’s request to decommission these ships early. Instead, the Navy proposed operating a select number of cruisers while inducting others into an ambitious modernization schedule.

However, what began as a plan to maintain readiness and combat capability quickly spiraled into a costly quagmire.

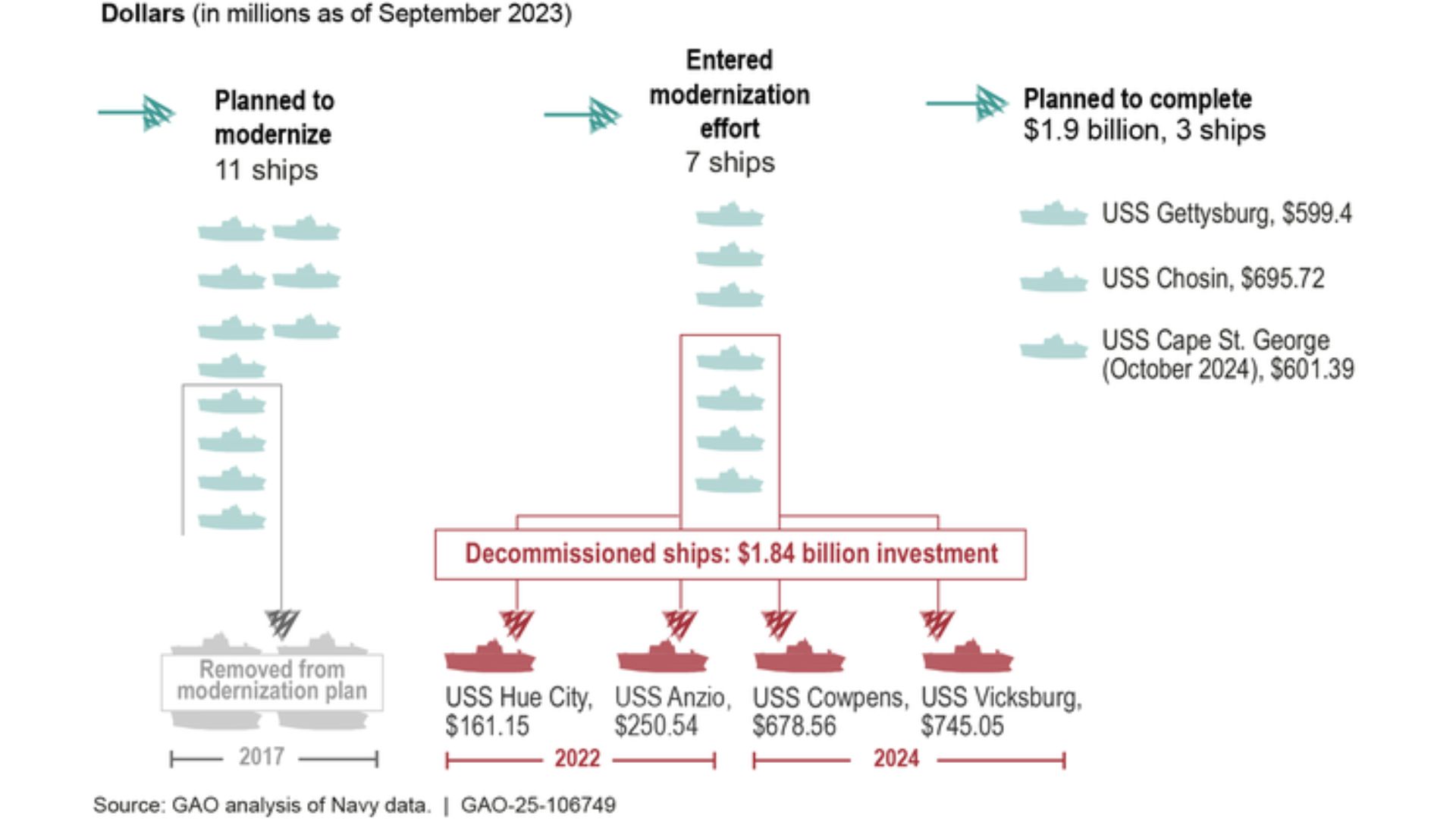

Between 2015 and 2019, seven cruisers entered modernization. Today, only three—USS Gettysburg (CG-64), USS Chosin (CG-65), and USS Cape St. George (CG-71)—have successfully completed the process or are nearing completion.

Meanwhile, four ships—USS Hué City (CG-66), USS Anzio (CG-68), USS Cowpens (CG-63), and USS Vicksburg (CG-69)—were decommissioned before modernization could be finalized, delivering no operational value despite nearly $2 billion invested.

USS Vicksburg
USS Vicksburg (CG 69) moored at Naval Station Mayport, 2015. (DVIDS)

Oversight and Coordination Failures

One of the most glaring issues highlighted by the GAO was the Navy’s failure to implement robust oversight mechanisms.

Unlike traditional acquisition programs, the cruiser modernization effort lacked the standard planning and accountability tools that might have helped prevent runaway costs and delays.
